2014 September to November

  • Granted two potash permits in south-eastern Saskatchewan
  • CGFPC reinterpreted 2D historical seismic exploration data in KL280 (KP 437) project area

2015 January to February

  • CGFPC completed desktop study of the environmental impact study (EIS) in KL280 (KP 437) project area in January

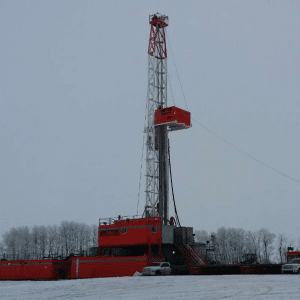

  • CGFPC completed three exploration drill holes from January to February in the  KL280 (KP 437) project area


2015 March to April

  • CGFPC  completed hydrological drilling of the environmental impact study (EIS) in KL280 (KP 437) project area in March

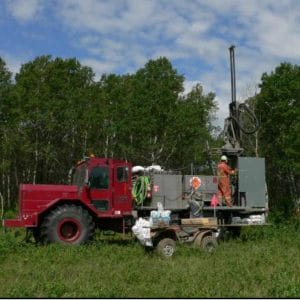

  • CGFPC reinterpreted 3D historical seismic exploration data in the KL280 (KP 437) project area from March to April
  • CGFPC completed preliminary estimate of Phase 1 three drill holes in April

2015 July

  • CGFPC finished 2D seismic exploration in KL282(KP 442) in July
  • CGFPC finished 3D seismic data in the KL280 (KP 437) project area in July

2015 August

  • CGFPC completed five exploration drill holes from June to August in the KL280 (KP 437) project area

2015 October

  • CGFPC completed NI 43-101 technical report, internal resource estimation report, and 3D model of subsurface mineral resource in October
  • CGFPC completed estimation mineral resource in the whole KL280 (KP 437) area and preparation of the internal resource estimation memo in October

2016 March to May

From March to May, CGFPC finished rock sample dissolution test. According to the results of dissolution tests, CGFPC created the brine dynamic and mass balance model. CGFPC also finished rock mechanical test on core samples


2016 September to December

  • CGFPC completed field investigation of well site in the KL280 (KP 437) project area on September
  • CGFPC is currently creating the dynamic model for cavern solution and processing flow

2017 - 2018

  • CGFPC completed preliminary design of railway line
  • CGFPC completed preliminary design of water pipeline system
  • CGFPC completed 4 rounds of community engagement and RM meetings
  • CGFPC completed Environmental Impact Assessment (EIA) and submitted Environmental Impact Statement (EIS)

2019-2022

  • The Environmental Impact Assessment of KL280(KP437) project received official approval from the Ministry of Environment
  • The Technical Project Proposal of water pipeline project was granted approval from the Ministry of Environment
  • CGFPC completed baseline groundwater mornitoring program for mine site
  • CGFPC completed field environmental data collection for the proposed rail spur line
  • CGFPC continues to work on detailed engineering aspect of the KL 280 project
  • CGFPC continues to work on transportation safety and efficiency plans for heavy equipment transport and potash taxation models

2025

The KL280(KP437) potash project will have tens of years of mining life.

2014 September to November
  • Granted two potash permits in south-eastern Saskatchewan
  • CGFPC reinterpreted 2D historical seismic exploration data in KL280(KP437) project area
2015 January to February
  • CGFPC completed desktop study of the environmental impact study (EIS) in KL280(KP437) project area in January
  • CGFPC completed three exploration drill holes from January to February in the KL280(KP437) project area

2015 March to April
  • CGFPC completed hydrological drilling of the environmental impact study (EIS) in KL280(KP437) project area in March
  • CGFPC reinterpreted 3D historical seismic exploration data in the KL280(KP437) project area from March to April
  • CGFPC completed preliminary estimate of Phase 1 three drill holes in April
2015 July
  • CGFPC finished 2D seismic exploration in KL282(KP442) in July
  • CGFPC finished 3D seismic data in the KL280(KP437) project area in July
2015 August
  • CGFPC completed five exploration drill holes from June to August in the KL280(KP437) project area
2015 October
  • CGFPC completed NI 43-101 technical report, internal resource estimation report, and 3D model of subsurface mineral resource in October
  • CGFPC completed estimation mineral resource in the whole KL280(KP437) area and preparation of the internal resource estimation memo in October
2016 March to May

From March to May, CGFPC finished rock sample dissolution test. According to the results of dissolution tests, CGFPC created the brine dynamic and mass balance model. CGFPC also finished rock mechanical test on core samples from KL280(KP437)

2016 September to December
  • CGFPC completed field investigation of well site in the KL280(KP437) project area on September
  • CGFPC is currently creating the dynamic model for cavern solution and processing flow
2017-2018
  • CGFPC completed preliminary design of railway line
  • CGFPC completed preliminary design of water pipeline system
  • CGFPC completed 4 rounds of community engagement and RM meetings
  • CGFPC completed Environmental Impact Assessment (EIA) and submitted Environmental Impact Statement (EIS)
2019
  • The Environmental Impact Assessment of KL280(KP437) project received official approval from Ministry of Environment
  • The water pipeline project was granted environmental approval from the Ministry of Environment
  • CGFPC  plans to start the construction of KL280(KP437) project
2025

The KL280(KP437) potash project will have tens of years of mining life.
